Key Takeaways
- LWIC is a poured system, not a board. Expanded polystyrene board is set into a wet slurry coat and then buried under a topping pour, so the insulation ends up encapsulated in concrete instead of fastened to the deck. Code requires a minimum of 2 inches of insulating concrete over the top plane of the substrate unless the product approval says otherwise.
- The insulation board is full of holes on purpose. Factory-cut holes let the slurry underneath and the topping above meet through the board and lock together. Those same boards get stair-stepped across the roof, and that is where slope to drain comes from. Nothing has to be cut and stacked, and there is no board joint for a slope transition to telegraph through.
- The R-value does not drift. The EPS used in these systems is nominal 1 pound per cubic foot expanded polystyrene, rated around R-3.85 per inch at a 75 degree mean temperature and slightly higher as the temperature drops. Polyiso moves the opposite direction, which is why NRCA has long told designers to calculate it below its label value.
- It sits outside the polyiso supply chain entirely. EPS is polystyrene chemistry. The fill is portland cement with either lightweight aggregate or pregenerated foam, batched locally. An LWIC assembly does not compete for MDI, which is the constraint that doubled polyiso lead times this year.
- It buys schedule on one end and spends it on the other. Crews can place a large roof area quickly, but the deck has to cure before the membrane goes on. The general guideline is 48 to 72 hours, longer when temperatures average below 50 degrees, and manufacturers want the deck roofed over within about 10 days. That trade belongs in the conversation early rather than at buyout.
Lightweight insulating concrete, usually shortened to LWIC, is a low-density cementitious fill poured over a roof deck with expanded polystyrene board cast inside it. It does two jobs in one placement. It insulates the roof, and it forms the slope to drain as a single monolithic surface rather than a stacked layout of cut tapered board. Because the fill cures in place and stays put, most LWIC decks can be re-roofed later without tearing out the insulation underneath.
It is also not structural lightweight concrete, which is a different material with a different job, and confusing the two is the most common error in specifications that reference LWIC. What follows is how the system is actually built, what it delivers thermally, and the conditions under which it is the wrong answer.
What is lightweight insulating concrete?
LWIC is a class of insulating concrete with an oven-dry density at or below 50 pounds per cubic foot, placed on a roof deck as insulation and as a substrate for the membrane. It carries foot traffic and rooftop work. It does not carry the building. Underneath it there is still a steel deck, a structural slab, a precast unit, or an existing roof that has been made watertight.
Building code recognizes three formulations, and they are separated by what creates the low density. Aggregate LWIC uses vermiculite or perlite meeting ASTM C332 Group I and has to reach a minimum compressive strength of 200 psi. Cellular LWIC replaces the aggregate with pregenerated foam and has a minimum of 160 psi. Hybrid mixes combine the two and return to the 200 psi minimum. All three are tested to ASTM C495 and C796.
The distinction that matters most to a specifier is against structural lightweight concrete. That material spans and carries load. It also runs far denser and insulates poorly. LWIC is built to insulate and to be shaped, with no structural capacity assumed. A drawing that calls for lightweight concrete without saying which one is a submittal problem waiting to happen.
Why is the insulation board full of holes?
The board inside an LWIC deck is expanded polystyrene, and it arrives on the roof perforated. The industry calls it holey board. It looks like an oversized foam building block, and the holes are the whole point of the design. Code language requires that the insulation panels be provided with holes or slots for keying and venting, and the panels have to be set into a slurry of insulating concrete at least an eighth of an inch thick while that slurry is still plastic.
When the topping pour goes on, concrete flows down through those openings and meets the slurry coat underneath. The board is now keyed between two layers of the same material rather than sitting on top of one, which is what resists uplift and makes the deck behave as one piece. The openings also give trapped moisture a path out.
Boards are commonly 2 feet by 4 feet, run from 1 inch to about 16 inches thick, and are typically nominal 1 pound per cubic foot. Thickness is how the assembly hits its R-value. Staggered thickness is how it gets its slope.
How does an LWIC roof deck get installed?
The sequence is short but the order is not negotiable. A slurry coat goes down first, generally half an inch to three quarters of an inch, filling irregularities in the substrate. Boards are set into that wet slurry and usually left overnight to dry. The topping pour follows, screeded to the finished slope.
| Layer | What it is | What it does |
|---|---|---|
| Substrate | Bottom-slotted galvanized steel deck, structural concrete, or a prepared existing roof | Carries the building load and, on slotted metal deck, gives moisture in the mix a downward path out |
| Slurry coat | A thin bottom pour of insulating concrete, roughly half an inch to three quarters of an inch | Fills substrate irregularities and creates the bed the insulation board is set into while still plastic |
| EPS holey board | Perforated expanded polystyrene, commonly 2 ft by 4 ft, nominal 1 pcf, 1 to 16 inches thick | Carries most of the assembly R-value and sets the slope profile through staggered board heights |
| Topping pour | Insulating concrete over the board, minimum 2 inches over the top plane of the substrate per code | Encapsulates the board, keys through its holes to the slurry below, and forms the finished slope to drain |
| Membrane | Base sheet and membrane, or a fleece-back single ply adhered directly on cellular systems | Waterproofs the assembly, anchored by fasteners that stop inside the concrete rather than piercing the deck |
Cure guidance runs 48 to 72 hours before the roof can go on, extended when ambient temperatures average below 50 degrees. Rain during the window is far less damaging than rain on rigid board, and moderate rain generally costs about one additional day of drying rather than a tear-out. Once cured, the deck is normally expected to be roofed over within about 10 days.
Two field tests confirm the pour, and both numbers belong in the submittal record. Wet density is checked by filling a 10 quart pail from a working batch, weighing it, and multiplying by three against the specified design density. After at least 48 hours of cure, a withdrawal test pulls a base sheet fastener from the deck, where the accepted minimum is 40 pounds of resistance and results above 60 pounds are common.
One detail often gets misread. Base ply fasteners anchor into the insulating concrete rather than passing through the structural deck, so fastener length is matched to topping thickness. A 2 inch topping takes a fastener of about 1.7 inches. Nothing punches through to the building below, which is why the system shows up so often where a roof penetration is a liability.
What R-value does LWIC deliver, and why does it hold?
Most of the thermal resistance comes from the EPS board. The concrete around it adds a modest amount that varies by mix and should be taken from the manufacturer’s data sheet. What makes the assembly interesting is not the peak number. It is that the number stays where it started.
| Material | R-value per inch at 75°F | At 40°F | At 25°F | Direction over time |
|---|---|---|---|---|
| EPS board used in LWIC systems (nominal 1 pcf, ASTM C578 Type I) | 3.85 | 4.17 | 4.35 | Stable. Air-filled cells, no blowing agent left to diffuse out |
| Polyiso, published label value | 6.0 to 6.5 | Declines | Declines further | Drifts down as blowing agent escapes, then drops further as the foam gets cold |
| Polyiso, NRCA design recommendation | 5.6 warm climates | 5.0 cold climates | 5.0 cold climates | NRCA has advised calculating below the label value since 1987 |
EPS is blown with pentane that leaves the cell structure early, so what remains is air. No blowing agent diffuses out over fifteen years and no gas condenses inside the cells on a cold morning, so its rated R-value climbs slightly as temperature falls. Polyiso does the reverse, which is why NRCA has recommended for decades that designers calculate polyiso at R-5.6 per inch in warm climates and R-5.0 in cold ones rather than at the label value.
An honest note for North Texas. Dallas Fort Worth sits in Climate Zone 3A, so the cold-temperature derating that drives this argument in Minnesota matters less here than national content suggests. The stronger local case is encapsulation. The board is sealed inside concrete, away from the seams and wet-insulation failures that quietly cost a board assembly its rated performance. Our post on R-value changes for polyiso covers what moves downstream when assembly thickness has to grow.
The mass of the topping does something else worth naming. Membrane aging roughly doubles for every 18 degree rise in membrane temperature, and the concrete above the board absorbs energy that would otherwise land on the membrane. On a DFW roof in August that is not a rounding error.
How does LWIC create slope to drain?
Slope is built by staggering the height of the EPS boards across the roof and then floating the topping over them. The finished surface is continuous. Crickets and saddles are formed in the same pour instead of being assembled from cut pieces, and there are no board joints for a slope transition to telegraph through.
KPost superintendent Billy Ward has described the work as a puzzle: manage the variance in roof slope with the EPS board, then float a layer of cellular concrete over it. On a re-roof that flexibility is the main event, because the system can add slope where there was none or change slope direction entirely without touching the structure.
There are limits. Cellular systems typically top out around three quarters of an inch per foot. Aggregate systems will go steeper, including barrel roofs, though labor cost climbs once slope passes an inch and a half per foot. Beyond those ranges the answer is a structural change, not a thicker pour.
Is LWIC a real answer while polyiso is on allocation?
It is, with conditions. Polyiso is made from MDI, and that constraint is what pushed roofing insulation from a three or four week order to an eight or ten week order this year. LWIC has no exposure to it. The board is polystyrene, and the fill is portland cement with aggregate or foam, batched from materials that move on local trucks rather than through a handful of Gulf Coast chemical plants. We covered that supply picture in our post on why polyiso lead times doubled in 2026.
What LWIC is not is a drop-in substitution. It is a different assembly, and it needs a compatible deck, a structural review, an approved applicator, plus a cure window the schedule can absorb. Switching to it after a delivery date has already been missed is the expensive version. Pricing it as a carried alternate at bid time is the cheap one, which is why KPost estimating looks at an LWIC option on commercial work as a matter of routine.
Why does the applicator matter more than the mix?
Code does not merely recommend a qualified installer here. It requires that application of all lightweight insulating concrete roof decks be performed by applicators approved by the deck system manufacturer, and that base ply fasteners carry a product approval for the specific system and the project’s design pressure. That language exists because the material is mixed and finished on the roof rather than delivered finished.
The practical consequence is that one specification produces very different roofs depending on who pours it. Wet density drifts when batching is sloppy. A topping placed over a slurry coat that had not dried loses the key that holds the board. A membrane set before the deck released its moisture blisters months later and nobody connects it back. None of that shows up in a submittal package.
Frequently asked questions
Bring the deck question into design
LWIC is one of those assemblies that gets ruled out early in design because nobody in the room has installed one, and then gets reconsidered eighteen months later when the insulation package will not ship. The better sequence is to price it while the drawings are still moving.
KPost Company self-performs lightweight insulating concrete alongside its commercial roofing and building envelope work across Dallas Fort Worth. If you have a commercial roof installation in design or preconstruction, contact our team and we will walk the deck options with you before the assembly is locked.
Technical values cited here are drawn from published code language, ASTM standards, and manufacturer system literature current as of September 2026. Compressive strengths, venting percentages, cure times, fastener requirements, and R-values vary by system and by product approval, and the governing document on any project is the approved submittal for the specific system being installed. Deck compatibility, added dead load, and code R-value compliance require review by the project’s design professionals and the system manufacturer.

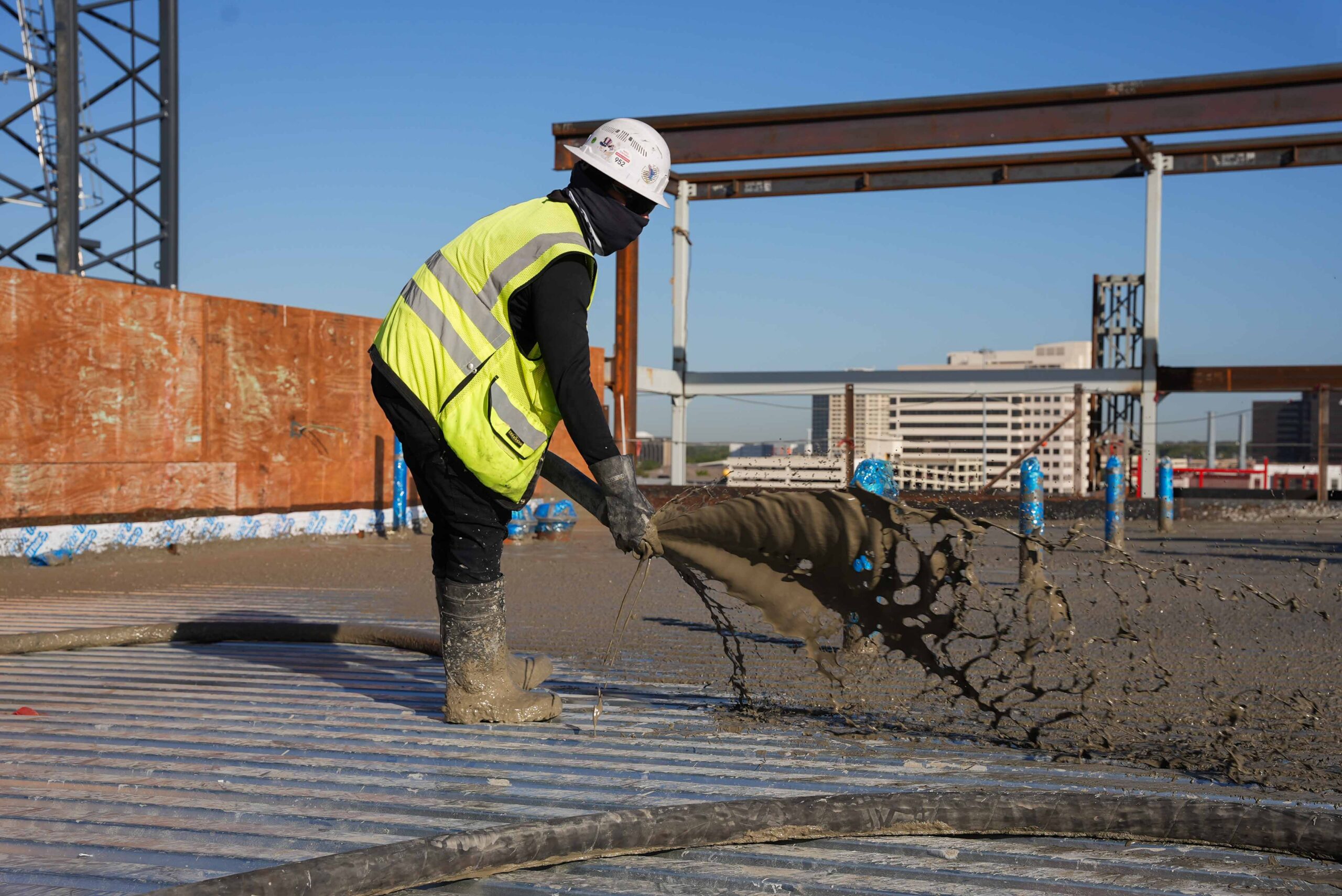

Before getting into specification, it helps to see LWIC being placed, so here are the key installation steps:
